Mitigating IT Project Risks with a Risk Breakdown Structure (RiBS)">
CPQ Guide

Mitigating IT Project Risks with a Risk Breakdown Structure (RiBS)

Jon Scott

Jon Scott

Jon Scott co-founded ScopeStack, a B2B SaaS solution that simplifies the scoping and pricing of IT services for organizations worldwide. With a background in both business and technology, Jon is dedicated to providing IT service providers with an efficient, data-driven platform that streamlines operations and drives business growth. Before starting ScopeStack, Jon worked as a Managing Solution Architect at Dimension Data, where he recognized the challenges organizations faced in scoping and pricing IT services. Along with his work at ScopeStack, Jon is an active community member who enjoys giving back and mentoring future technology professionals. He lives in the Upstate of South Carolina with his beautiful wife and two adorable children.

5 min read
Mitigating IT Project Risks Using a Risk Breakdown Structure (RiBS)

When IT projects go out of scope, budget, or fail to meet success criteria, it is rarely due to one major failure. More often, it’s the accumulation of smaller, overlooked risks that compound with time. A missed dependency here, an underestimated integration there—then by the end of your timeline, you’re weeks behind scheduling. For MSPs and solution providers, risk isn’t just theoretical, but should be baked into every configuration, quote, and deployment you deliver.

A risk breakdown structure (RiBS) provides project managers with a way to transform risk management from reactive firefighting into proactive planning. When used correctly, it helps identify, quantify, and mitigate threats before they impact your deliverables, client relationships, and margins.

What is a Risk Breakdown Structure (RiBS)?

A risk breakdown structure (RiBS) is a hierarchical framework that categorizes potential project risks into tiers, starting from broad categories and progressing to more specific, actionable items. An example of a broad category is “technical risks,” while a granular scenario could be as detailed as “API version compatibility issues.” For IT projects, this hierarchical approach mirrors how modern systems are architected—layered, interconnected, and requiring analysis at multiple levels.

The high-level categories for a risk breakdown structure often include:

  • Technical risks: outdated hardware, integration incompatibilities, system failures, or underperforming APIs
  • Organizational risks: internal resource constraints, skill gaps, or turnover
  • External risks: vendor delays, regulatory changes, and supply chain issues
  • Project management risks: scope creep, timeline extensions, or communication breakdowns

From these categories, items get more granular, including subcategories, specific areas, and individual scenarios.

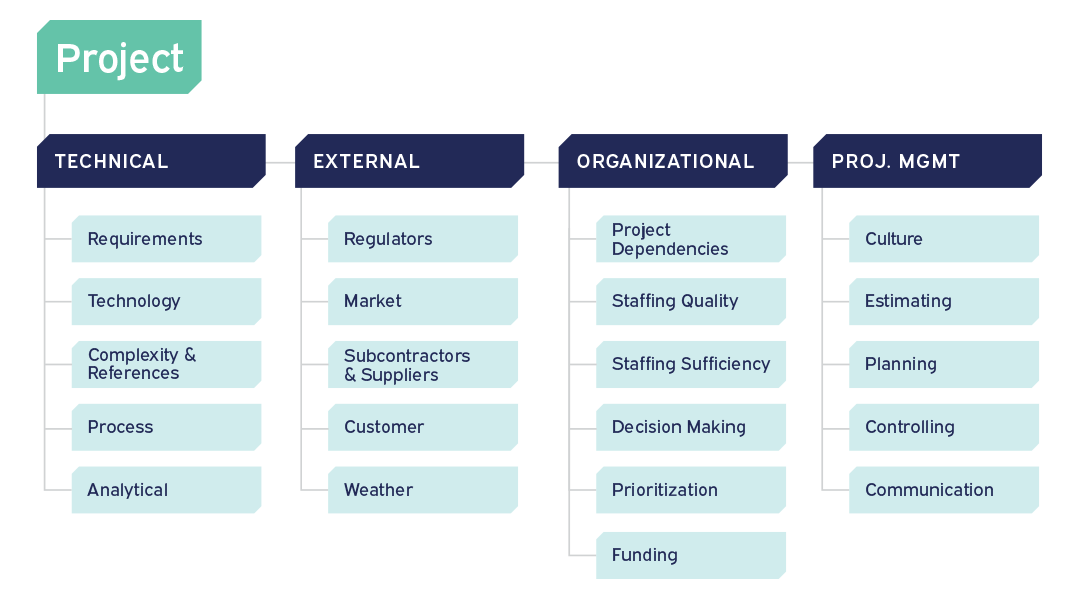

Example Risk Breakdown Structure

Why is RiBS important for IT projects?

Managed service projects carry unique risk profiles that generic frameworks often miss. When deploying infrastructure or migrating systems, you’re dealing with risks, such as version compatibility, that are unique to this industry. These variables often can make or break profitability. Without a structured approach to manage these unknowns and variations, surprises will inevitably arise and erode margins.

A RiBS helps MSPs and solution providers:

  • Expose hidden dependencies: Projects often involve layers of third-party software or hardware. Mapping risks ensures you see the chain reaction before it happens.
  • Quantify exposure: Each identified risk can be scored for likelihood and impact (high, medium, low), helping teams focus resources where they matter most.
  • Communicate clearly with clients: A structured risk plan builds transparency and trust when clients see that you’ve anticipated potential issues.
  • Protect profitability: Understanding risk up front allows you to price appropriately, allocate the right resources, and avoid eroding profit margins mid-project.

PMI research shows projects employing structured risk management are 2.5 times more likely to meet their original goals. For IT service providers operating on slim margins with projects that have moving parts, identifying a critical issue during discovery instead of delivery can mean the difference between profit and loss.

What should a Risk Breakdown Structure include?

For IT service providers, your RiBS should reflect the actual risk landscape of modern technology projects. While every project is unique, most IT initiatives share common risk categories mentioned previously: technical risks, organizational risks, external risks, and project management risks.

From there, an RiBS should descend into at least three levels of hierarchy:

  • Level 1: Major risk categories (such as technical, external, organizational, and project management)
  • Level 2: Subcategories within each (for example, under “technical,” you might include “software defects” or “system compatibility”)
  • Level 3: Specific risks that are directly measurable or actionable (e.g., “integration failure due to API version mismatch”)

For each identified risk, document the context surrounding it:

  • Description: What the risk is and how it could impact the project
  • Probability: The likelihood it will occur (low, medium, high)
  • Impact: The potential severity if it occurs (low, medium, high)
  • Mitigation strategy: The steps to prevent or minimize the risk
  • Owner: The team member responsible for monitoring it

Benefits of using an RiBS in IT projects

Beyond identifying problems before they become expensive, a properly implemented RiBS delivers strategic benefits:

1. Improved estimation accuracy

Instead of adding a blanket buffer for quotes—such as a standard additional 20% variance for all projects—you can build in appropriate contingencies based on actual risk exposure. High-risk items receive a larger buffer, while low-risk items receive a smaller one, making estimates both competitive and realistic.

2. Smarter prioritization

Instead of rating all risks equally, you can rank them and address high-impact areas first. This lets you tackle the riskiest issues first, bringing more stability and confidence to the project.

3. Better client relationships

When you've documented risks in your statement of work (SOW) with mitigation strategies, problems become anticipated scenarios you're handling professionally rather than unexpected failures. Clients respect the forethought and are less likely to feel blindsided.

4. Faster issue resolution

Because you've already thought through potential solutions, your team executes contingency plans rather than starting from scratch.

5. Resource optimization

Planning for riskier areas helps better allocate resources and personnel where they are needed most. If your RiBS identifies high-risk integration work in weeks 3-5, you can schedule senior architects accordingly.

6. Knowledge retention and improvement

Over time, your RiBS becomes an organizational knowledge base. It maintains a historical record of recurring risks across projects. This guides smarter scoping, allowing new project managers to lean on lessons from previous projects rather than learning the hard way.

Ultimately, RiBS transforms risk management from a reactive scramble into a predictable, data-driven process.

Examples of Risk Breakdown Structures in IT projects

Different project types require tailored risk structures. Here are practical examples:

1. Cloud migration project

Technical risks →

Infrastructure migration →

Network connectivity →

  • VPN tunnel
  • Bandwidth adequacy

Technical risks →

Infrastructure migration →

Data transfer →

  • Database replication lag
  • File integrity validation

External risks →

Vendor dependencies →

Cloud provider SLAs →

  • Service availability during migration
  • API rate limiting

2. ERP system integration

Technical risks→

Integration architecture →

API connectivity →

  • Rate limiting on sync jobs
  • Webhook delivery reliability

Project management risks →

Scope management →

Custom requirements→

  • Undocumented workflows
  • Department-specific process variations

3. Cybersecurity implementation

Technical risks→

Security architecture→

Zero trust implementation →

  • Legacy authentication compatibility
  • MFA enrollment resistance

Organizational risks→

User adoption →

Training effectiveness →

  • Security awareness comprehension
  • Password manager adoption

How to build a risk breakdown structure

Building a RiBS can be done collaboratively across technical and delivery teams using these steps:

1. Start with risk categories, then customize

Use the major risk categories—technical, organizational, external, and project management—and then customize based on your project type. An MSP handling managed services will develop different organizational risks than a VAR focused on one-time implementations.

2. Brainstorm specific risks

Bring together technical teams, project managers, and salespeople during the discovery phase. Each team has insights that another team may overlook. Use prompting questions like, "What technical dependencies exist?” and “What client factors could impact the timeline?” to list potential risks.

3. Classify risks

Arrange the risks hierarchically to reflect dependencies or common causes.

4. Score and prioritize

Assign probability and impact ratings. This risk score prioritizes mitigation efforts. High-probability, high-impact risks demand immediate attention; low-probability, low-impact risks just need monitoring. Assign a responsible party to own each risk response.

5. Develop mitigation strategies

Outline preventive and contingency actions. Determine a plan of action to reduce occurrences, minimize the impact, identify triggers, and establish specific responses.

Remember to review your RiBS regularly, as risks revolve as projects progress. You can update the RiBS at key milestones and after each project, ensuring it remains accurate for future reference.

Integrating RiBS into a comprehensive project management plan

A RiBS works best when it’s not siloed. Tie it directly to your WBS, SOW, and change control process, so every identified risk connects back to actual deliverables and costs.

For instance:

  • During project scoping: Use the RiBS to flag potential unknowns that might expand the scope or timeline.
  • During execution: Use it to monitor risk triggers, such as delayed dependencies or increased workload on critical paths.
  • During closure: Document lessons learned and update your template to improve forecasting for future projects.

Connecting RiBS and ScopeStack for better risk management

Risk management becomes more efficient when tying it to your ScopeStack CPQ flow. It’s beneficial to reduce the workload when you are dealing with multiple projects across clients.

1. Logging riskier work

If a specific service consistently introduces high-impact risks (such as cloud migrations or network redesigns), ScopeStack can log that information into your project templates. Quotes can include a particular estimate of risk associated with those types of tasks moving forward.

2. Tracking and monitoring risks

Data from your ticketing software feeds back to ScopeStack. With this project management feature, you can track risks over time, adjusting your resources and deliverables as needed to ensure optimal performance. This visibility helps prevent costly overruns.

3. Clear client communication

With ScopeStack, teams can include risk mitigation plans and related costs directly within SOWs. This ensures that clients are aware of how risks could impact scope, budget, and delivery timelines, thereby preventing misunderstandings later.

The key is making risk management practical. Your RiBS should be specific enough to drive action, integrated throughout your project lifecycle, and continuously refined based on experience. When you demonstrate awareness of risks competitors haven't considered, you're not just managing projects better—you're differentiating your service offering.

When paired with a platform like ScopeStack, RiBS evolves from a static chart into a dynamic, living framework that ties risk management directly into scoping, pricing, and delivery.

If you’re ready to reduce your uncertainty in projects and improve margins, book a demo today.
